Mumbai Metro with 10 lines being built to serve Mumbai
RAILWAYS & METRO RAIL

Mumbai Metro with 10 lines being built to serve Mumbai

Mumbai Metro with 10 lines is an urban Mass Rapid Transit System (MRTS) being built to serve Mumbai, Maharashtra’s capital and largest city.

Its development has been entrusted to the Mumbai Metropolitan Region Development Authority (MMRDA), who in 2004 came out with a 146.5 km master plan with multiple lines. Due to various issues which range from policy paralysis (EPC vs PPP, metro rail vs monorail) to environmental issues, the MMRDA has so far only been able to develop 1 metro line in the suburbs connecting Versova – Andheri East – Ghatkopar.

In 2015, a new 118 km master plan was approved and the then incumbent government provided much needed impetus for the development of 2 lines: Dahisar East – Andheri East (Red Line) and Dahisar East – D.N. Nagar (Yellow Line) in addition to the Cuffe Parade – BKC – Aarey Colony (Aqua Line).

In June 2019, a new nodal agency called Maha Mumbai Metro Operations Corporation (MMMOCL) was established for operating and maintaining all Mumbai Metro services on lines owned by MMRDA. In September 2019, the MMRDA unveiled a new 337 km master plan for Maha Mumbai Metro’s network consisting of 10 lines (total of 17 sections).

The Delhi Metro Rail Corporation has lent its services as the interim General Consultant for the execution of most lines.

Key Figures

Operational: 11.4 km | Under Construction: 169.061 km | Approved: 21.289 km | Proposed: 136.4 km


Line

Terminals / Corridor

Length (Km)

Stations

Status

Line-1

Verova – Andheri – Ghatkopar

11.4

12

Operational

Line-2A

Dahisar (E) – DN Nagar

18.60

17

Under Construction

Line-2B

DN Nagar – Mandale

23.64

22

Under Construction

Line-3

Cuffe Parade – BKC – Seepz – Aarey Colony

33.50

27

Under Construction

Line-4

Wadala – Kasarawadavali

32.32

32

Under Construction

Line-4A

Kasarawadavali – Gaimukh

(extn of Line-4)

2.88

2

Under Construction

Line-5

Thane – Bhiwandi – Kalyan

24.95

17

12.811 km Under Construction; Rest On-Hold

Line-6

Swami Samarth Nagar – Vikhroli

15.18

13

Under Construction

Line-7

Dahisar (E) – Andheri (E)

16.5

14

Under Construction

Line-7A

Andheri (E) – CSI Airport

(extn of Line-7)

3.17

2

Under Construction

Line-8

CSIA – NMIA

(Airport Connector)

35

7

Proposed

Line-9

Dahisar (E) – Mira Bhayander

(extn of Line-7)

11.38

8

Under Construction

Line-10

Gaimukh – Shivaji Chowk in Mira Road

(extn of Line-4)

9.20

4

Approved

Line-11

Wadala – Chhatrapati Shivaji Maharaj Terminus

(extn of Line-4)

12.77

10

Proposed

Line-12

Kalyan – Taloja

(extn of Line-5)

20.7

17

Proposed

Line-13

Shivaji Chowk (Mira Road) – Virar

23

20

Proposed

Line-14

Kanjurmarg – Badlapur

45

40

Proposed


On February 28, 2020 – the MMRDA unveiled official line colors as part of a major branding exercise to establish style guidelines with help from Systra MVA Consulting.
Mumbai Metro – Operational Lines
Line-1 – Blue Line: Versova – Andheri – Ghatkopar (11.4 km, 12 stations)
• Operator: Mumbai Metro One Private Ltd. [JV of Reliance Infra (69%), MMRDA (26%) and Veolia Transport (5%)]
• Stations: Versova, D.N. Nagar, Azad Nagar, Andheri, Western Express Highway (WEH), Chakala, Airport Road, Marol Naka, Saki Naka, Asalpha, Jagruti Nagar, Ghatkopar
• Depot: Four Bungalows (DN Nagar)
Mumbai Metro – Under Construction Lines
Line-2A – Yellow Line: Dahisar (East) – D.N. Nagar (18.589 km, 17 stations)
• Owner: Mumbai Metropolitan Region Development Authority (MMRDA)
• Operator: Maha Mumbai Metro Operations Corporation (MMMOCL)
• Depot: Malvani in Charkop (shared with Red Line)
Line-2B – Yellow Line: D.N. Nagar – Bandra – Mandale (23.643 km, 22 stations)
• Owner: Mumbai Metropolitan Region Development Authority (MMRDA)
• Operator: Maha Mumbai Metro Operations Corporation (MMMOCL)
• Depot: Mandale
Line-3 – Aqua Line: Cuffe Parade – BKC – SEEPZ – Aarey Colony (33.5 km, 27 stations)
• Owner and Operator: Mumbai Metro Rail Corporation Ltd [50-50 JV of GOI and GoMH]
• Depot: Aarey Colony
Line-4 – Green Line: Bhakti Park (Wadala) – Ghatkopar – Thane – Kasarvadavali (32.32 km, 32 stations)
• Owner: Mumbai Metropolitan Region Development Authority (MMRDA)
• Operator: Maha Mumbai Metro Operations Corporation (MMMOCL)
• Depot: Vikhroli and Mogharpada
Line-5 – Orange Line: Thane – Bhiwandi – Kalyan (23.50 km, 17 stations)
• Owner: Mumbai Metropolitan Region Development Authority (MMRDA)
• Operator: Maha Mumbai Metro Operations Corporation (MMMOCL)
• Depot: Kon Village (Kalyan)

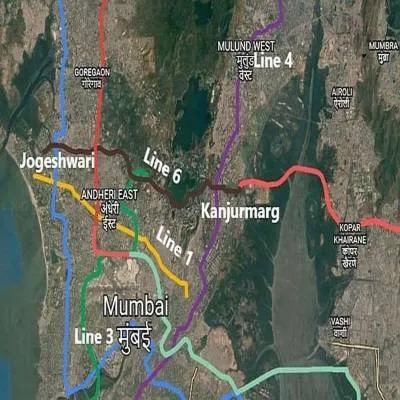

Line-6 – Pink Line: Lokhandwala – JVLR – SEEPZ – Kanjurmarg (14.47 km, 13 stations)
• Owner: Mumbai Metropolitan Region Development Authority (MMRDA)
• Operator: Maha Mumbai Metro Operations Corporation (MMMOCL)
• Depot: Kanjur Village (Kanjurmarg) along EEHLine-7 – Red Line: Dahisar (East) – Andheri (East) (16.5 km, 14 stations)
• Owner: Mumbai Metropolitan Region Development Authority (MMRDA)
• Operator: Maha Mumbai Metro Operations Corporation (MMMOCL)
• Depot: Malvani in Charkop (shared with Yellow Line) and Dahisar East
Fares for the rest of the lines have not been set or revealed yet. In February 2020, the MMRDA announced the M-Cube Metro Travel Card for transport across the Mumbai Metropolitan Region. Further details are awaited.

Latest Mumbai Metro tender notices can be viewed on MMRDA’s website.

Image source
